ERPX Manufacturing / Subcontracting

Manage subcontracted production and supplier-held materials

Track materials sent to subcontractors, production still in progress and finished goods received back from suppliers.

ERPX subcontracting order, receipt, and bill of materials shown in one collage

At a glance

Subcontracted production

Subcontracting lets a supplier perform production work using materials supplied by your business. ERPX tracks supplier-held stock and links returned goods to the subcontracting order.

Back to Manufacturing

Features

What you can manage with subcontracting

Key tools for managing this part of your production process.

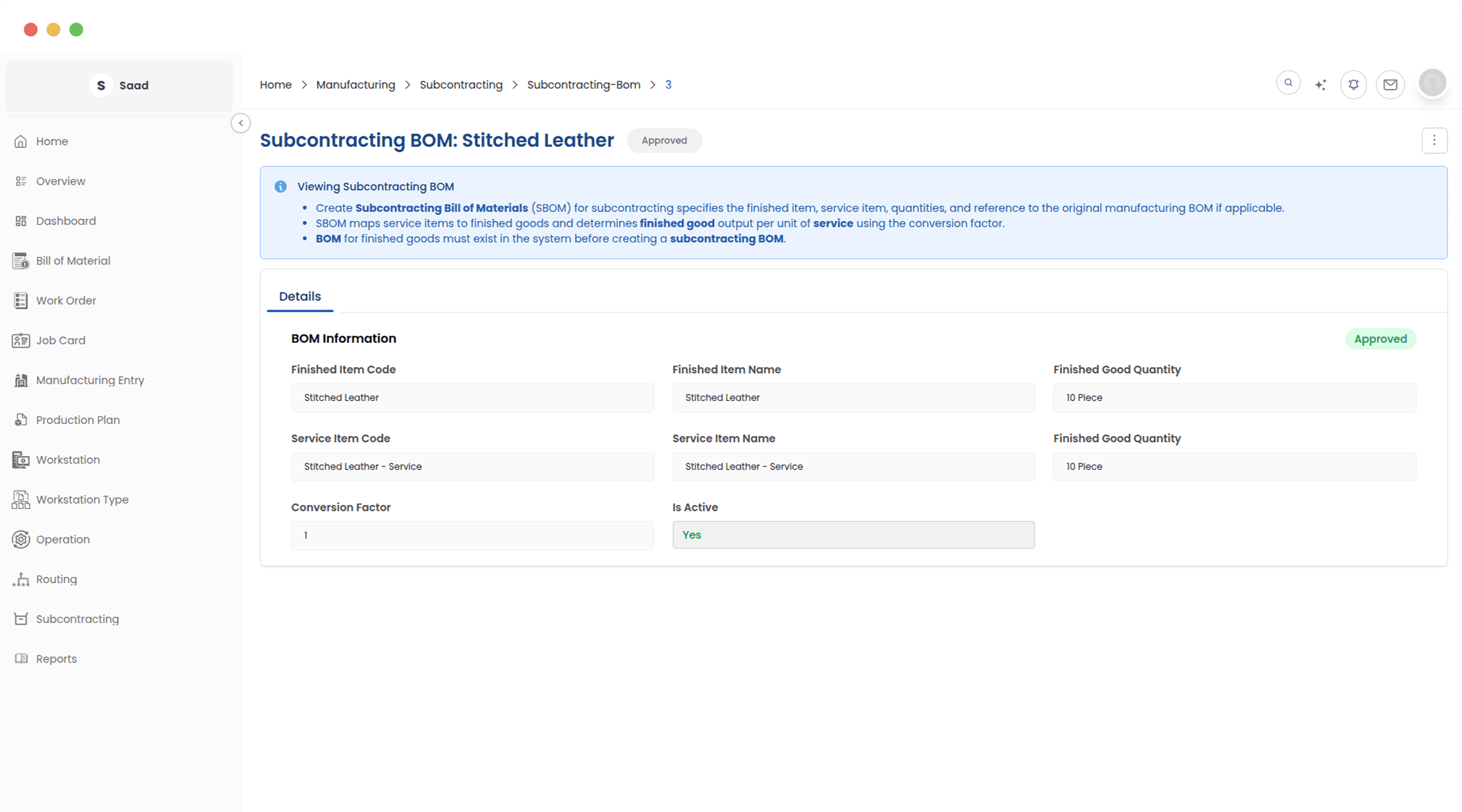

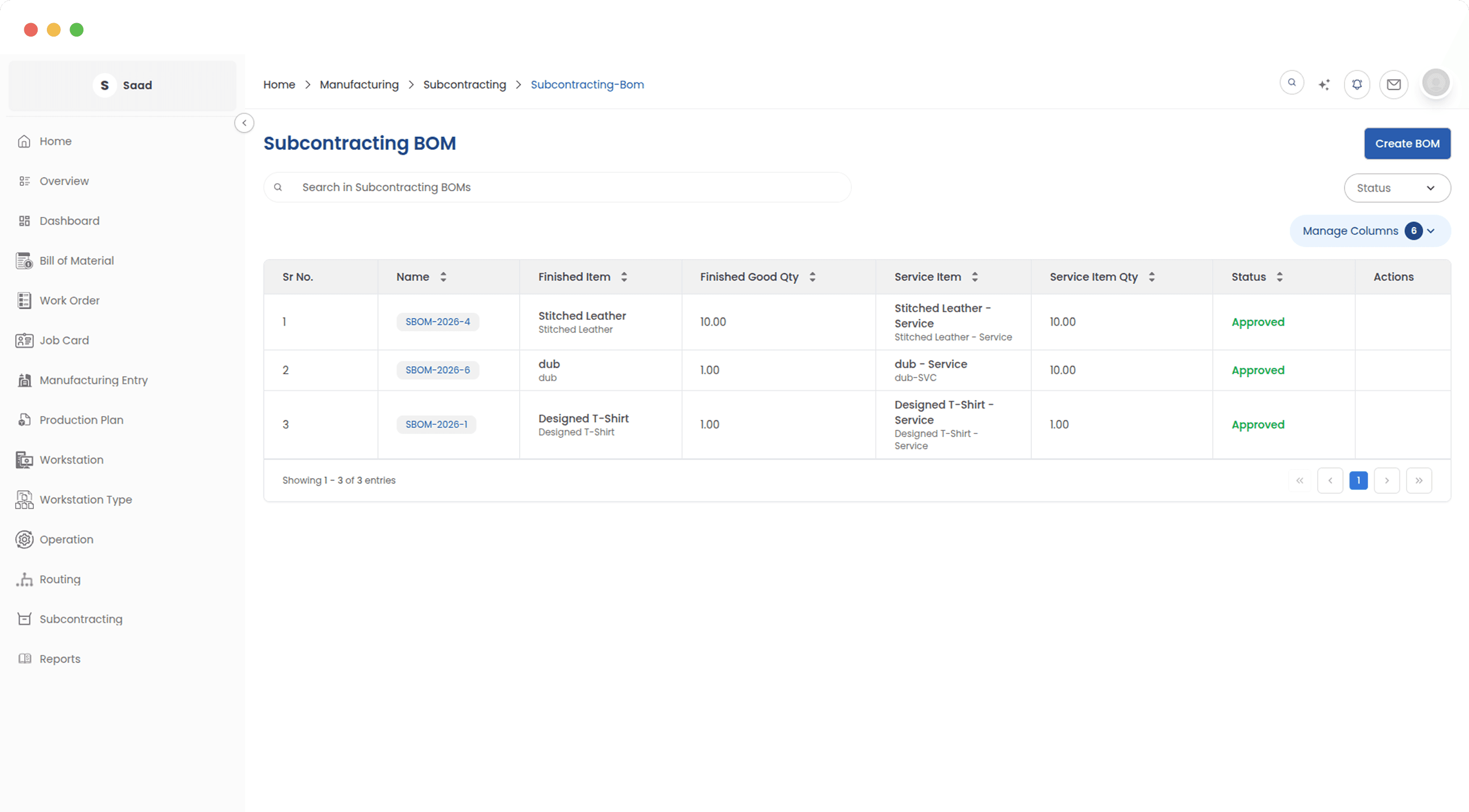

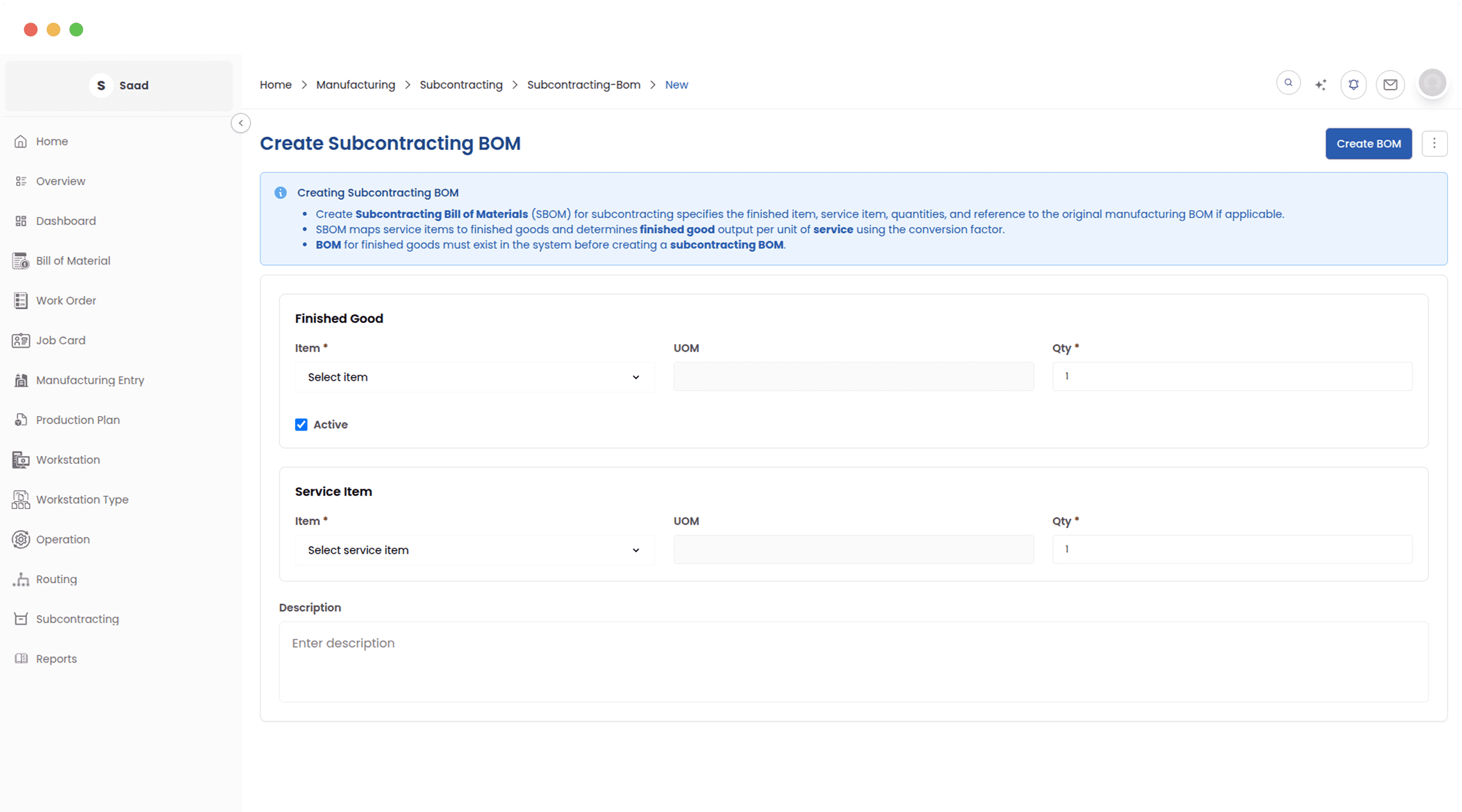

A BOM for the supplier’s work

Define the materials to supply, the item to receive and the supplier responsible for production.

Supplier warehouse inventory

Keep company-owned material visible at the supplier’s premises, with stock movements for each dispatch.

Partial transfers and receipts

Send material and receive output in several batches against the same subcontracting order.

Outstanding supplier work

Separate materials still to be sent from goods still to be returned, with dates and order status for follow-up.

Inside Subcontracting

Production workflows in ERPX

See how teams use ERPX to manage production records and day-to-day work.

Material ownership

Know how much of your stock is at each supplier

A supplier warehouse holds material during outsourced production in the same way WIP holds material for an in-house run. Sending material changes its location; it remains part of your inventory.

  • Prepare the subcontracting BOM and order

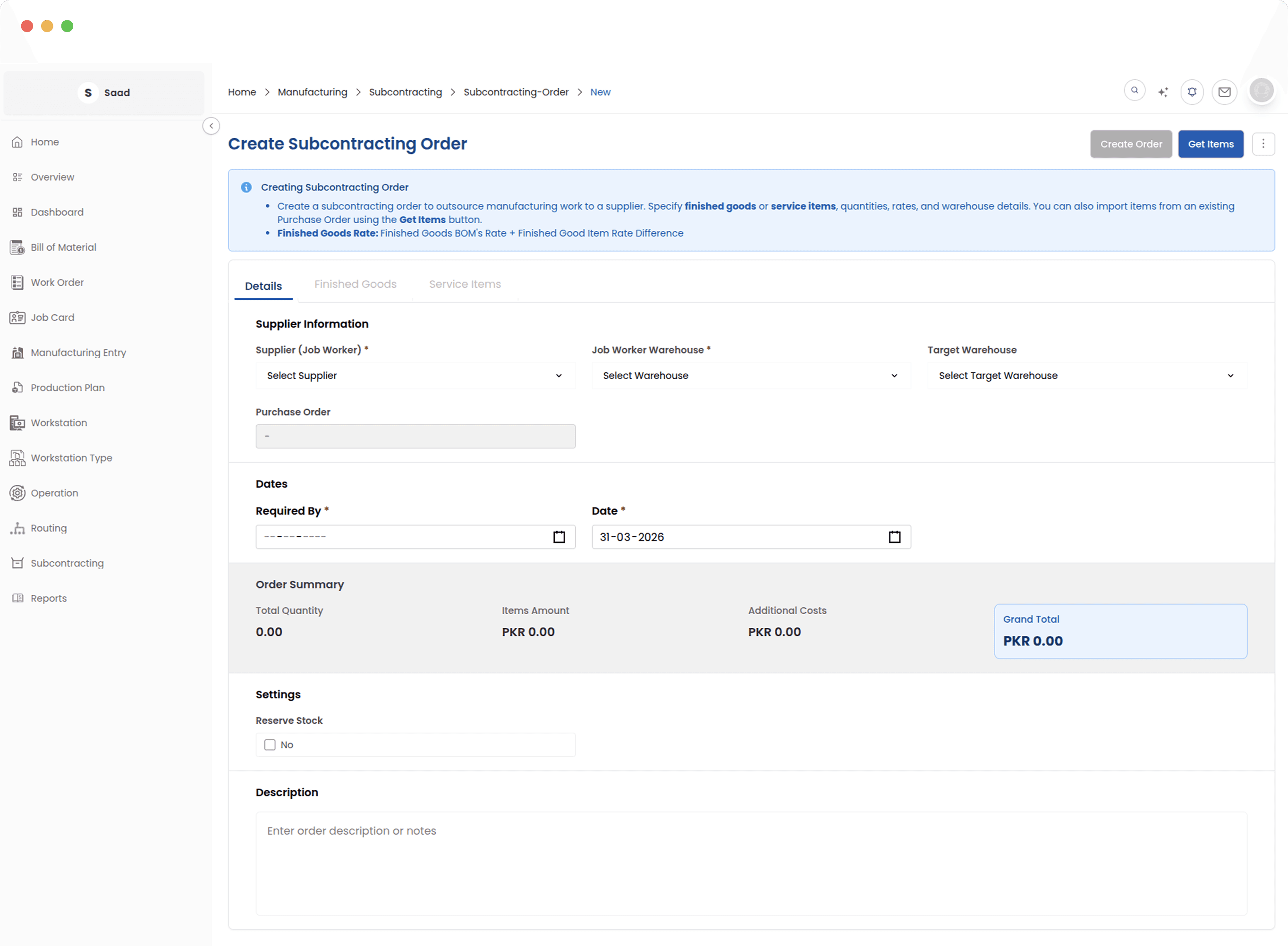

    Choose the supplier, output item and supplied materials. Edit the recipe through Subcontracting BOM so its linked BOM stays consistent. Approve the order before transferring material.

  • Transfer what was physically dispatched

    Transfer Materials creates a stock entry into the supplier warehouse. Partial dispatches remain visible as Partial Material Transferred, with the unsent balance available in the outstanding-transfer report.

  • Use a separate warehouse for each supplier

    Keep supplier balances distinguishable and reconcile them against the material the vendor says they hold. Supplier capabilities can also identify vendors suited to an outsourced operation.

Returned production

Consume supplied material when returned goods are received

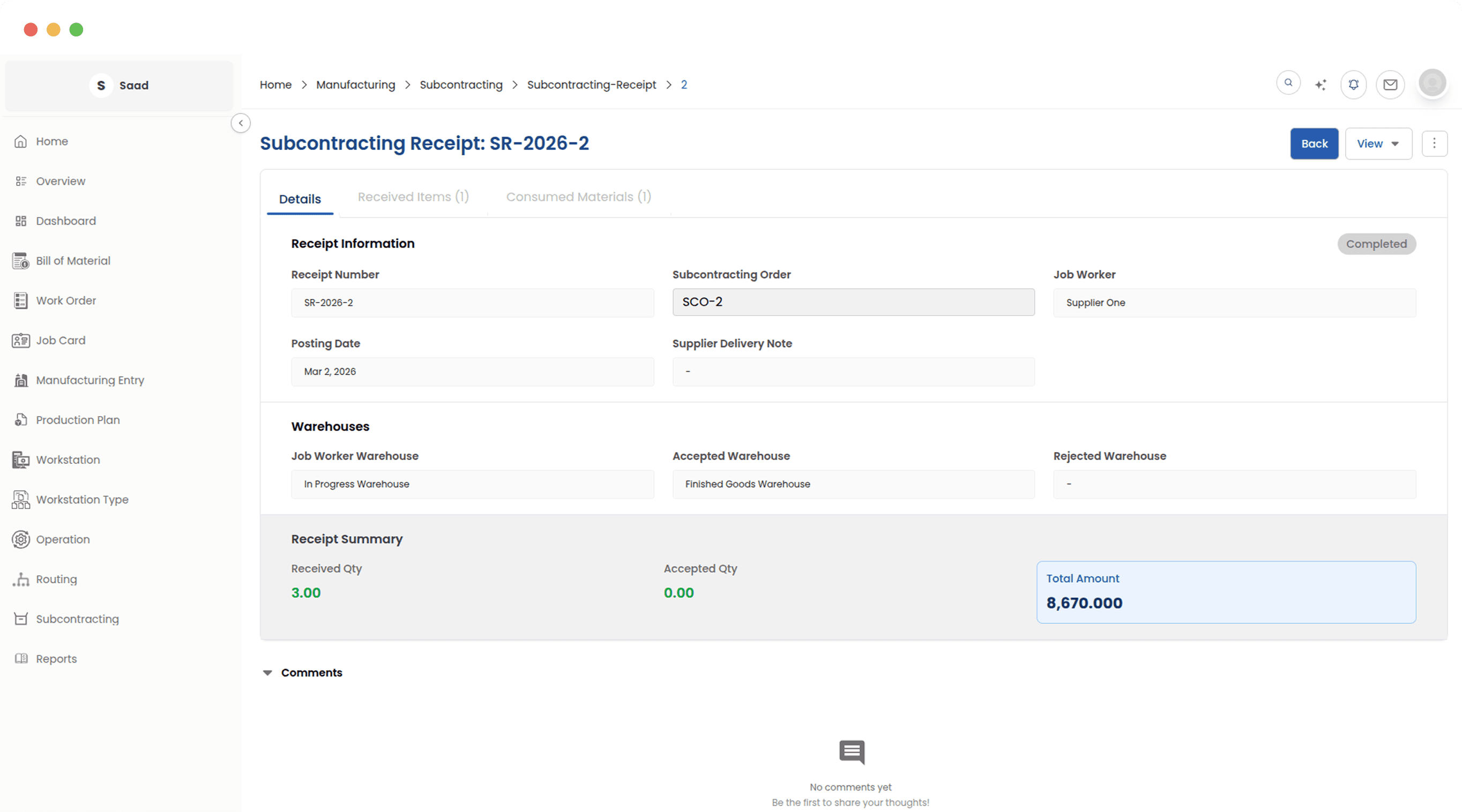

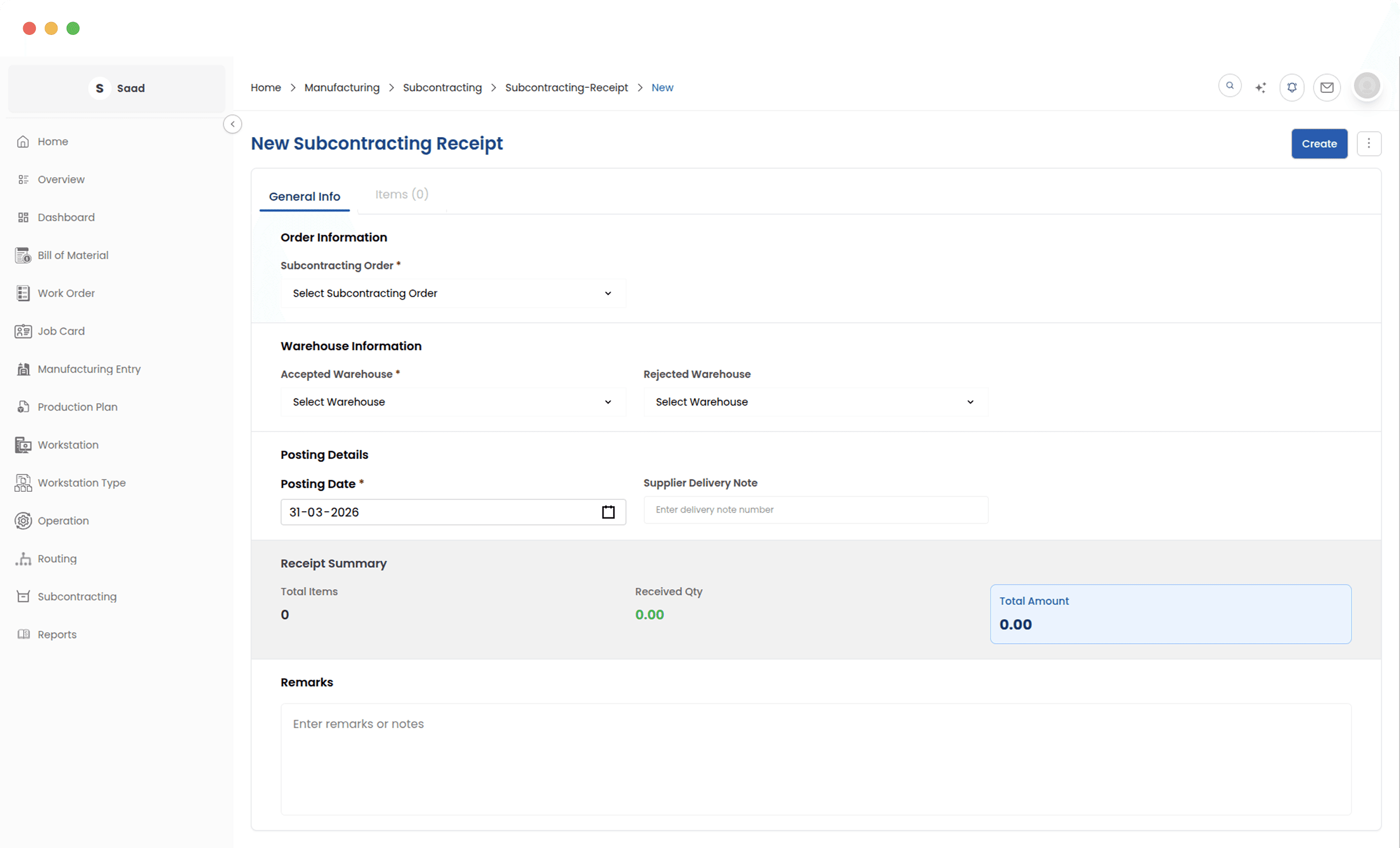

Approve a Subcontracting Receipt to consume material in the supplier warehouse and receive the finished or semi-finished item into your warehouse. Receipt quantity drives BOM-based consumption.

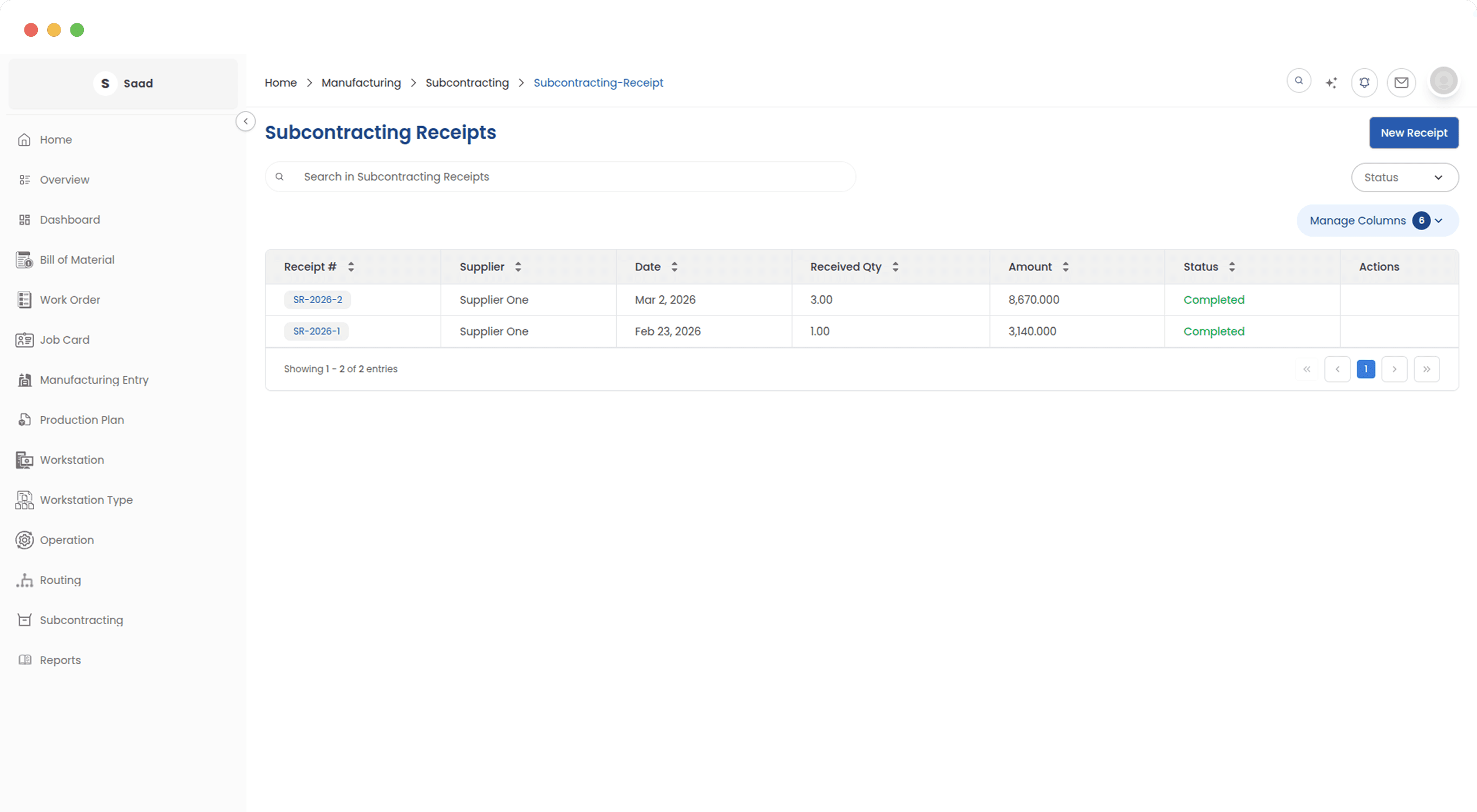

  • Receive each delivery against the same order

    Create several receipts as goods arrive. The order remains Partially Received until the full quantity has been received, then reaches Completed and can be Closed.

  • Check both the output and the consumed input

    Review receipt quantities before approval: an incorrect output quantity also consumes the wrong amount of supplied material. Receipt records include return and return-issued states for goods sent back.

  • Follow up the correct outstanding balance

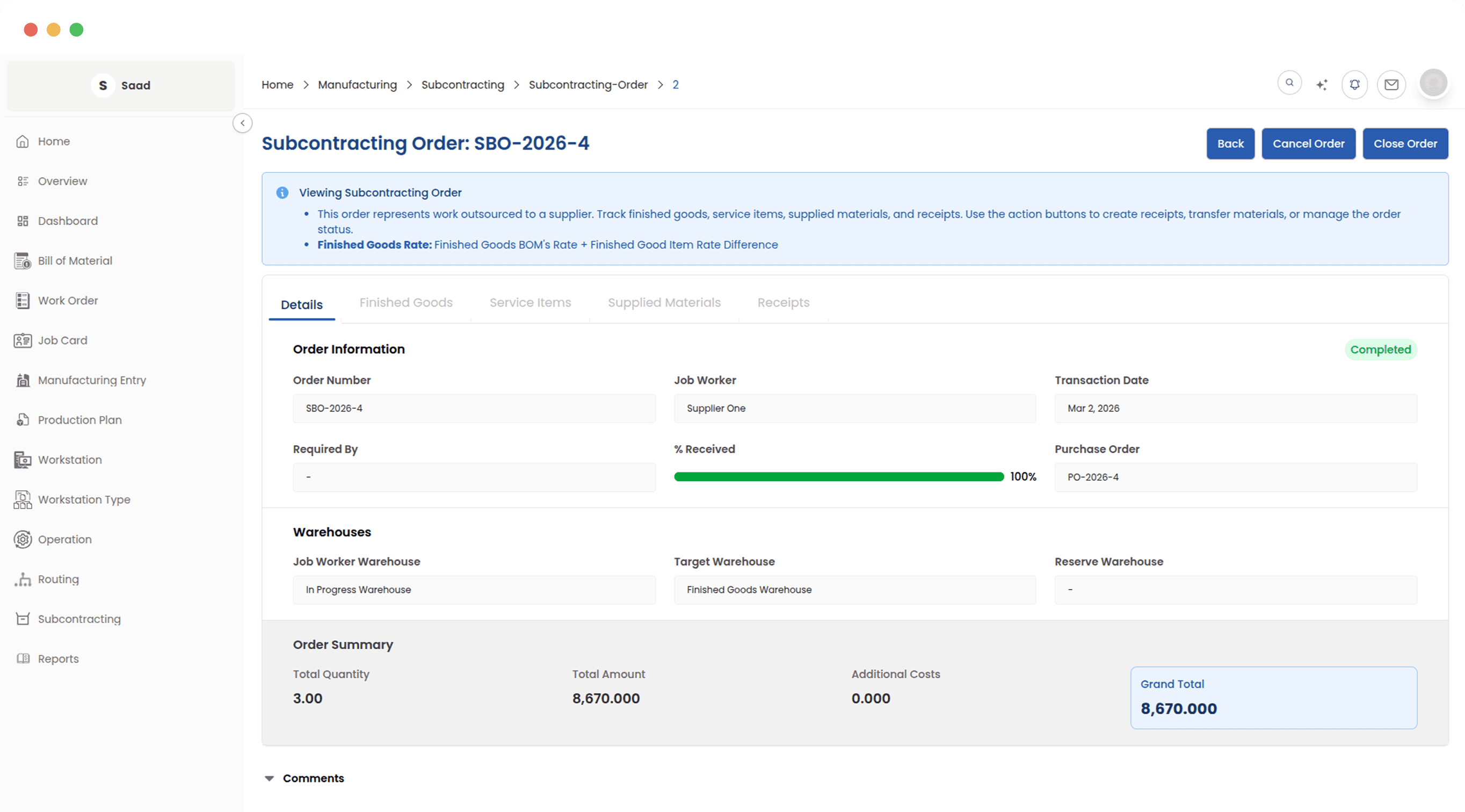

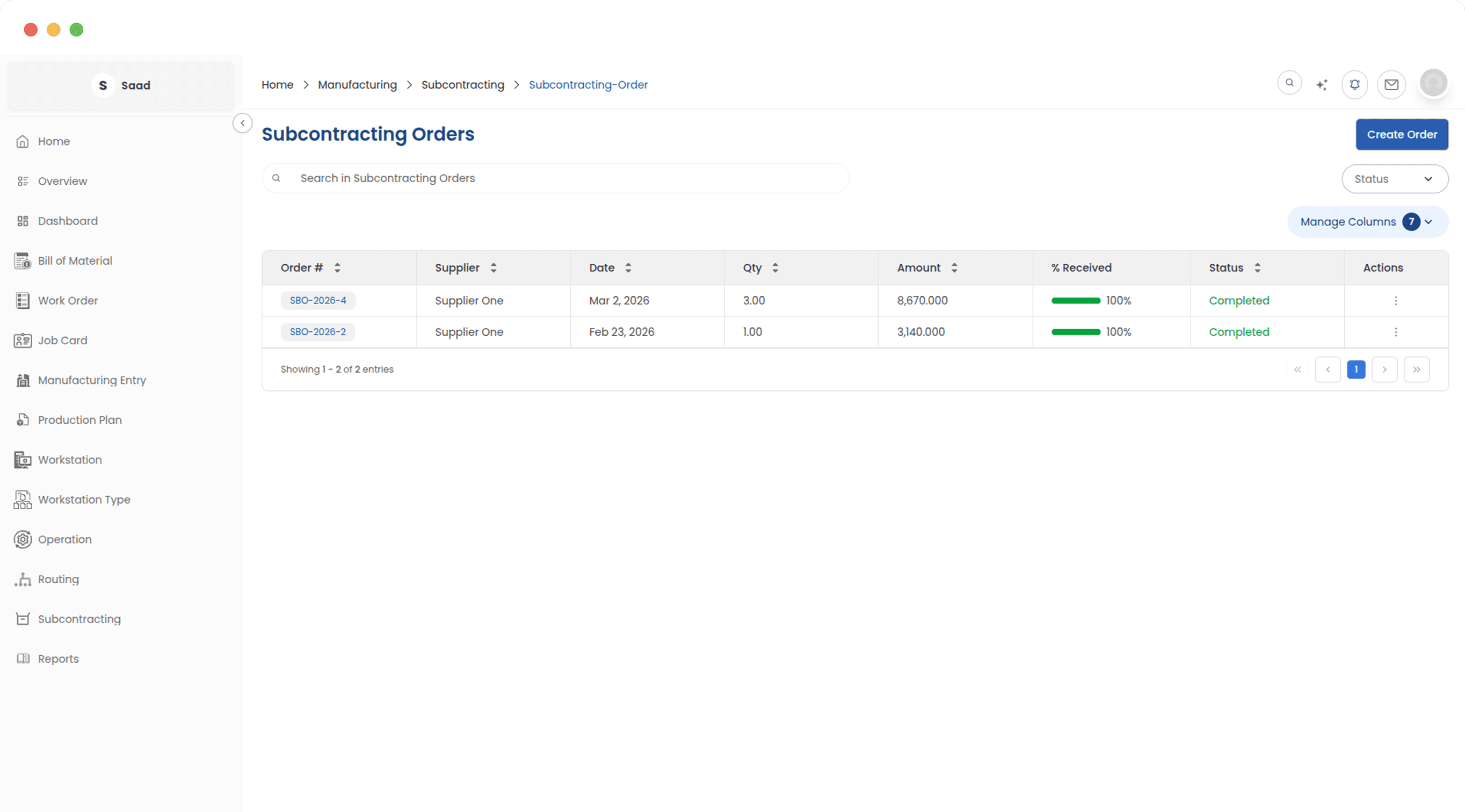

    Materials To Be Transferred identifies what your team still needs to send. Items To Be Received identifies output owed by the supplier. The order summary brings status, dates and received progress together.

ERPX subcontracting receipt detail for returned goods linked to a supplier order
Consume supplied material when returned goods are receivedApprove a Subcontracting Receipt to consume material in the supplier warehouse and receive the finished or semi-finished item into your warehouse. Receipt quantity drives BOM-based consumption.

Production example · illustrative figures

Example: receiving outsourced stitching in batches

Illustrative order: a supplier will stitch 1,000 shirts from 1,000 supplied fabric kits. Each receipt consumes one kit per shirt, with no loss or other warehouse movements.

Example: receiving outsourced stitching in batches
ActionKits held by supplierShirts received to dateShirts still due
Transfer 600 of the 1,000 kits60001,000
Receive the first 250 shirts350250750
Transfer the remaining 400 kits750250750
Receive another 250 shirts500500500
Receive the final 500 shirts01,0000

After the first receipt, 350 kits remain as your stock at the supplier and 400 kits still need dispatching. The supplier’s remaining 750-shirt commitment is a different balance from either material figure.

Product documentation

Product guides for production teams

Find setup, production and reporting guidance for this part of ERPX Manufacturing.

Connected manufacturing workflows

ERPX AI

Subcontracting without the back-and-forth

  • Manage subcontracting BOMs
  • Create subcontracting orders and receipts
  • Each document waits for your approval
See AI in Manufacturing

Buyer questions

Subcontracting questions

Yes. The transfer moves them into a supplier warehouse and they remain your stock. Approving a subcontracting receipt consumes the supplied material according to the subcontracting BOM and receives the returned item.

Yes. Material transfers and receipts can both be partial. Record each dispatch and delivery against the same order. Transfer and receipt statuses distinguish material waiting to be sent from output waiting to come back.

Use Items To Be Received for ordered goods the supplier has not returned, with expected delivery dates and pending quantities. Use Materials To Be Transferred for raw material your team still needs to dispatch. Check Subcontracting Order Summary for the wider order status and reconcile old balances with the supplier.
