Consolidated demand
Bring eligible sales-order lines into one plan or add manual replenishment demand, then confirm quantities and BOMs.
ERPX Manufacturing / Production & Capacity Planning
Turn demand into material requirements and work orders. Check production schedules against workstation capacity before releasing work.

At a glance
A production plan turns demand into manufacturing and purchasing requirements. Use it to review finished goods, sub-assemblies and raw materials, then create the documents needed to start the work.
Back to ManufacturingProduction & Capacity Planning
Capacity planning checks whether planned production can fit available workstations and hours. ERPX uses operation times and batch sizes to show the expected schedule and workload.
Explore production schedulingFeatures
Key tools for managing this part of your production process.
Bring eligible sales-order lines into one plan or add manual replenishment demand, then confirm quantities and BOMs.
Review finished and sub-assembly stock utilisation before calculating the raw-material shortage.
Choose how intermediate items will be supplied and create the manufacturing or subcontracting documents from the approved plan.
Create work orders, job cards and purchase requests, then follow produced, requested and received quantities against the plan.
Calculate using FIFO or Earliest Deadline, or arrange plans manually when a business commitment needs a different priority.
Read the production dependency tree, calendar timeline and workstation utilisation to see when and where work will run.
Identify overloaded resources, missing operation setup and work that exceeds a delivery date or the selected planning horizon.
Simulate additional demand and compare a fresh calculation with a saved snapshot before deciding how to adjust capacity.

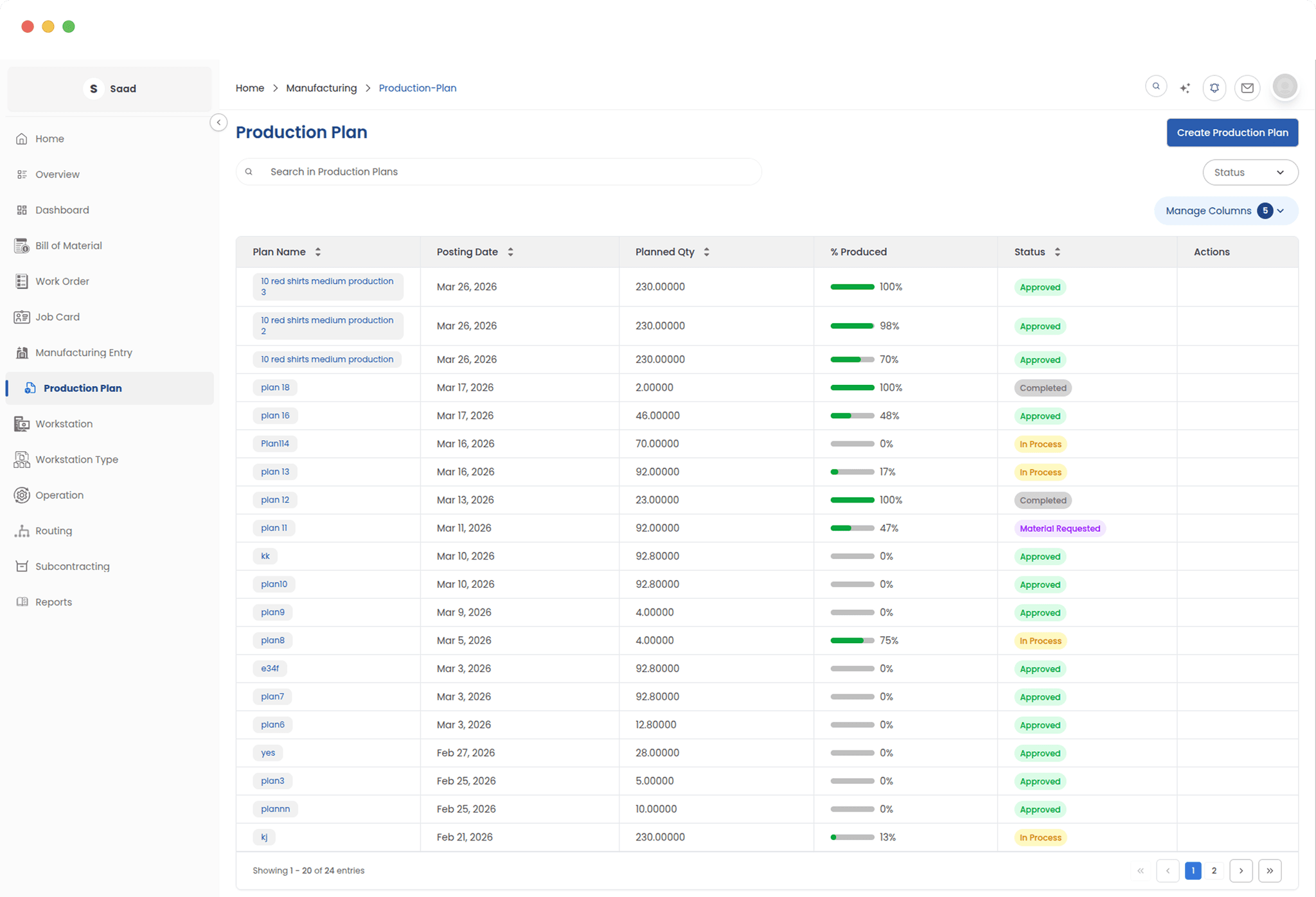

Inside Production & Capacity Planning
See how teams use ERPX to manage production records and day-to-day work.
Material requirements planning

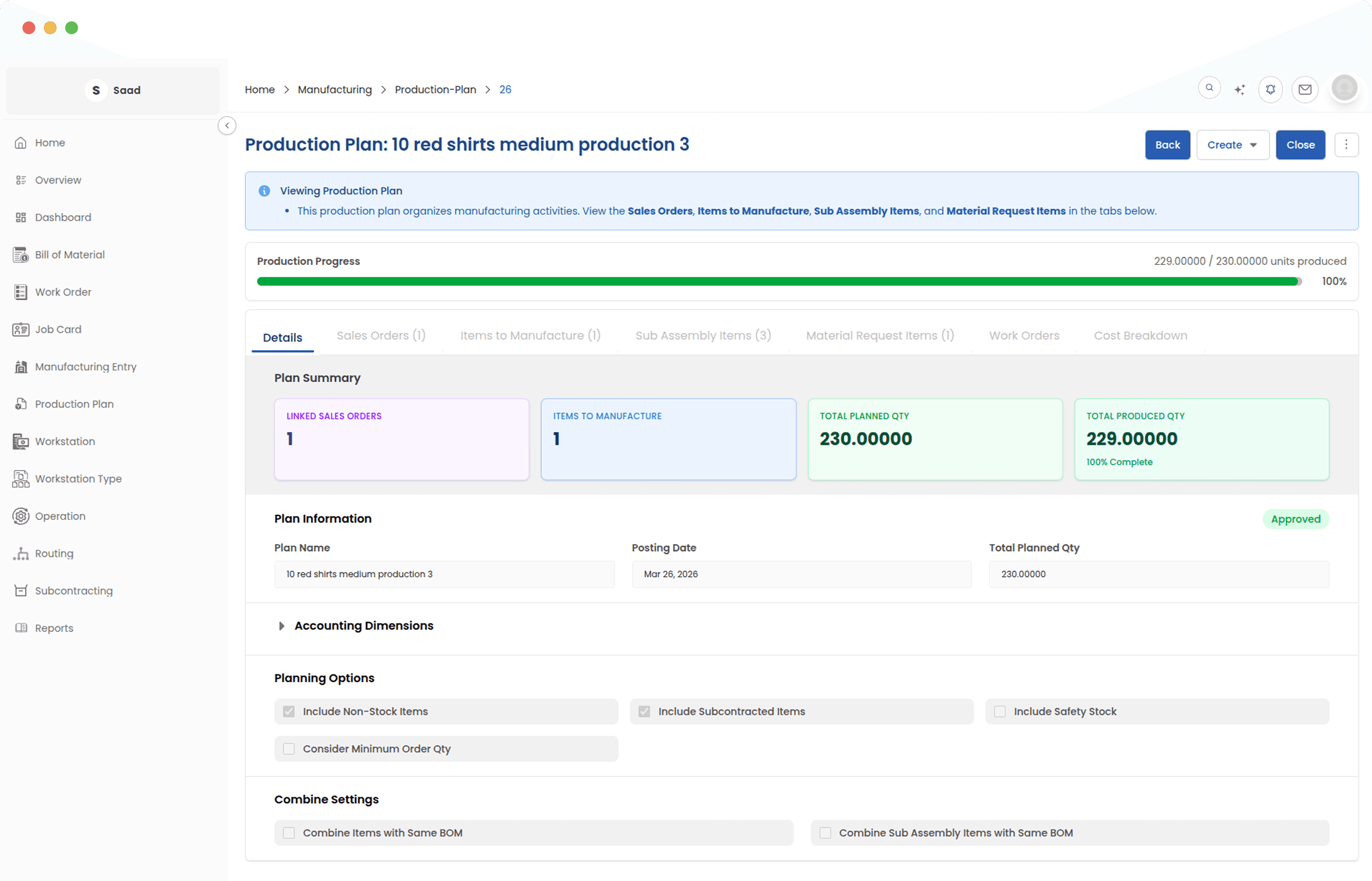

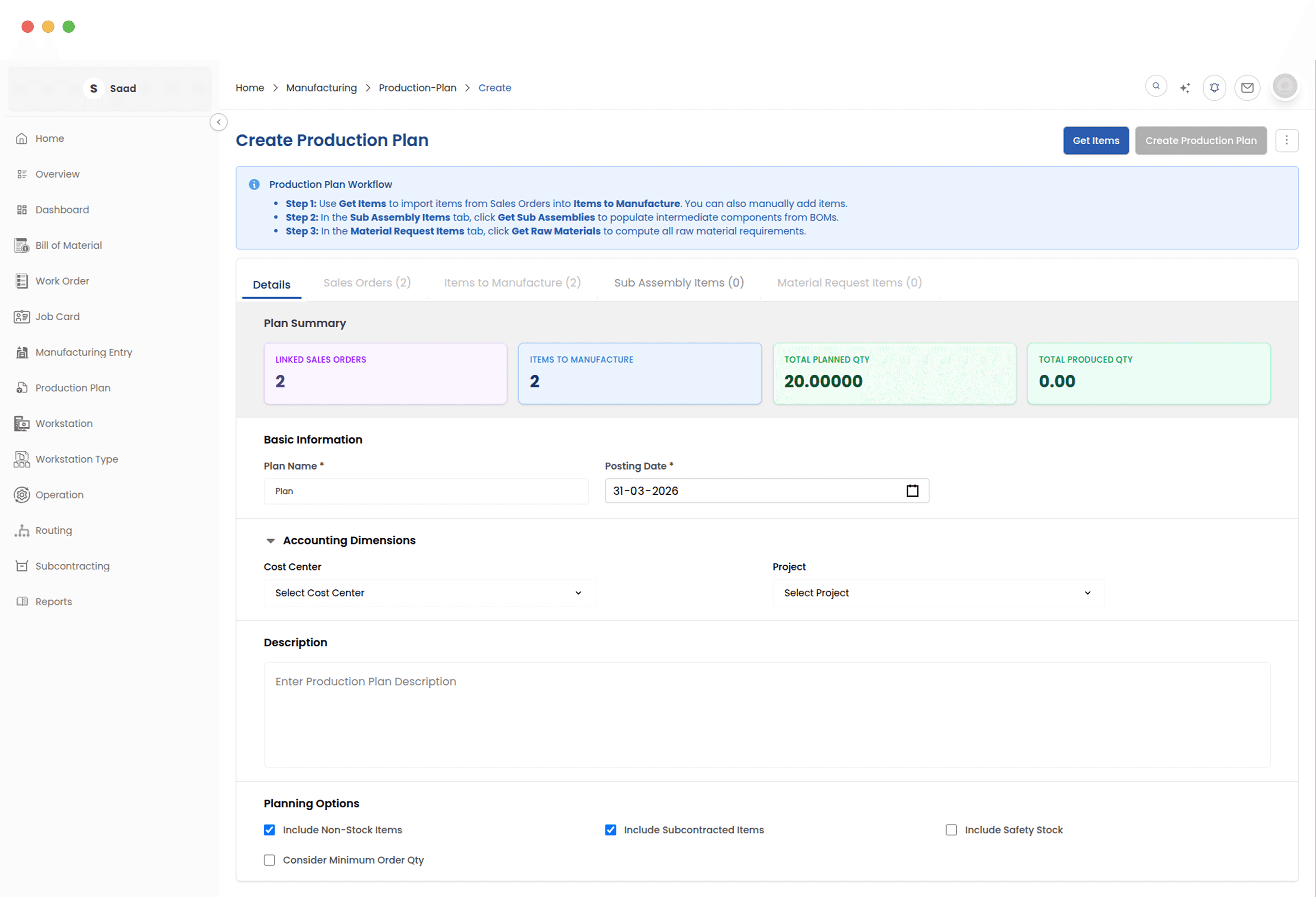

Start with customer demand, confirm stock to use, then load the sub-assemblies and raw materials. Shared components contribute to a consolidated requirement that purchasing can review.
Review the BOM, planned quantity, finished stock utilisation and order quantity for each item. Adjust imported demand for practical batches before accepting the production quantity.
Load sub-assemblies and review stock at each level. Choose In House or Subcontracted for each item, keeping the supply decision visible alongside the demand.
Get Raw Materials calculates the requirement after stock has been considered. Check BOM batch quantities, units, minimum-order settings and inclusion of non-stock or subcontracted items before requesting purchases.

From plan to execution
Approve the plan once quantities are settled. Its linked documents carry out purchasing and production, while the plan keeps the wider demand and progress visible.

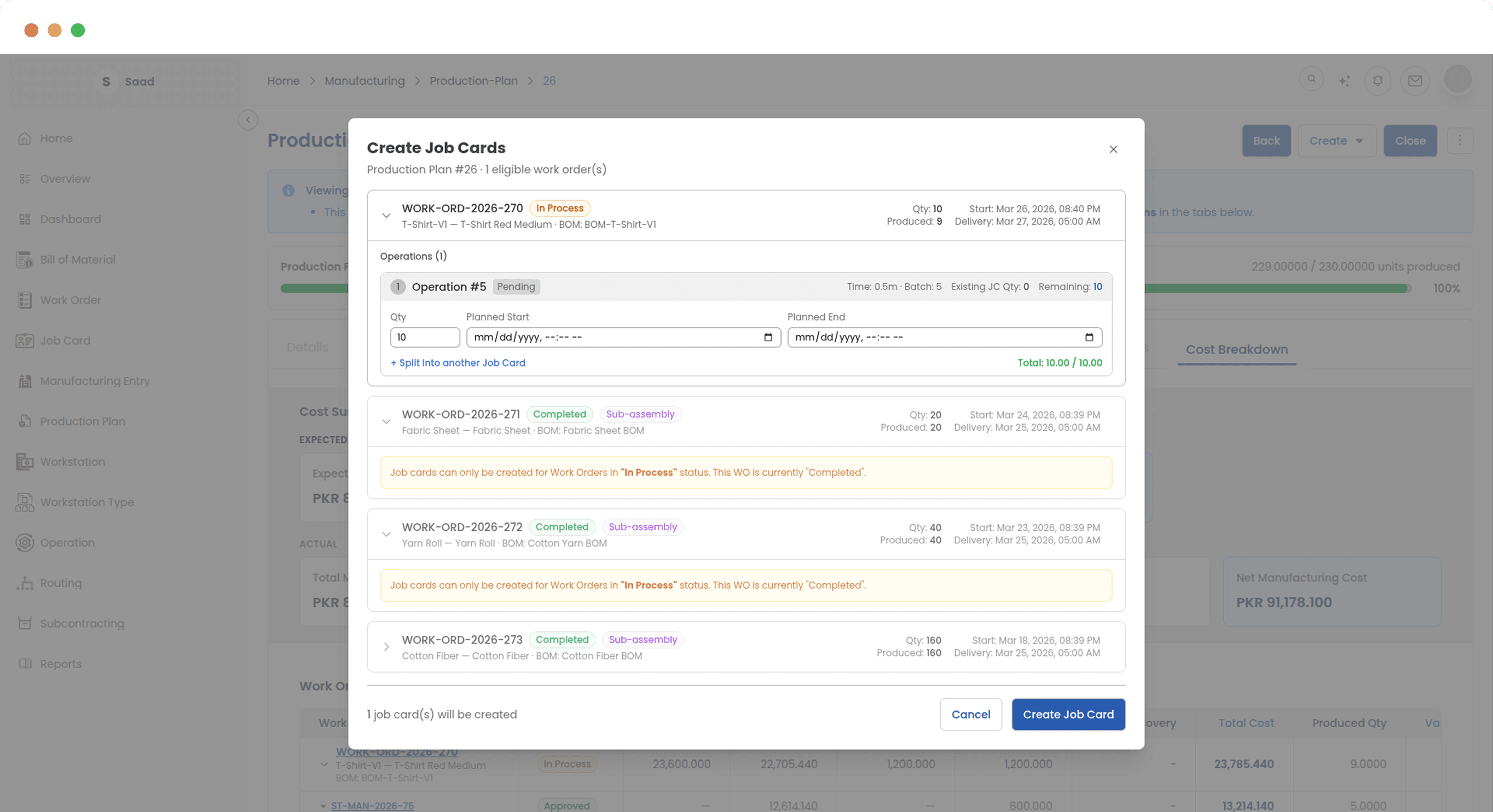

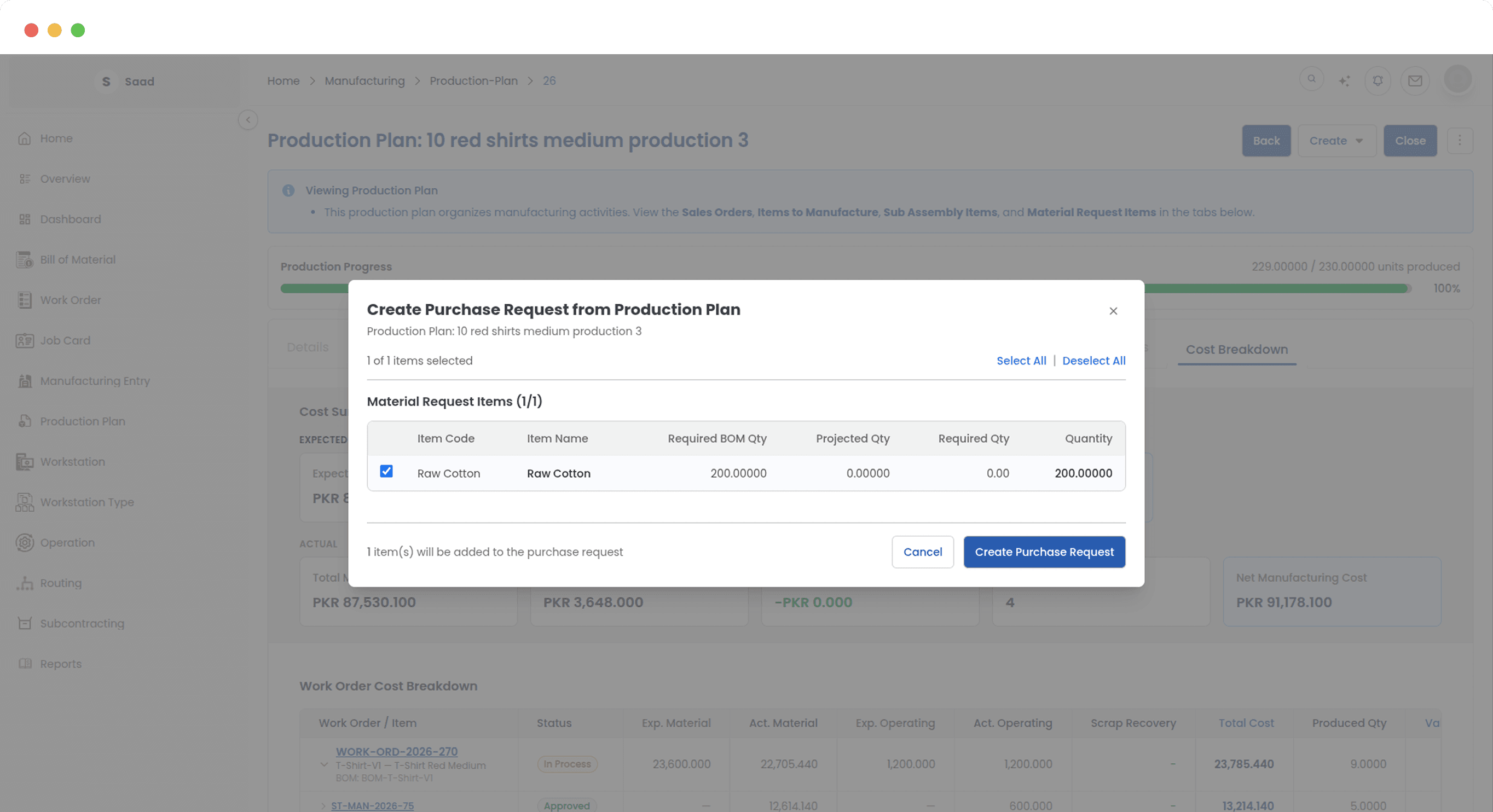

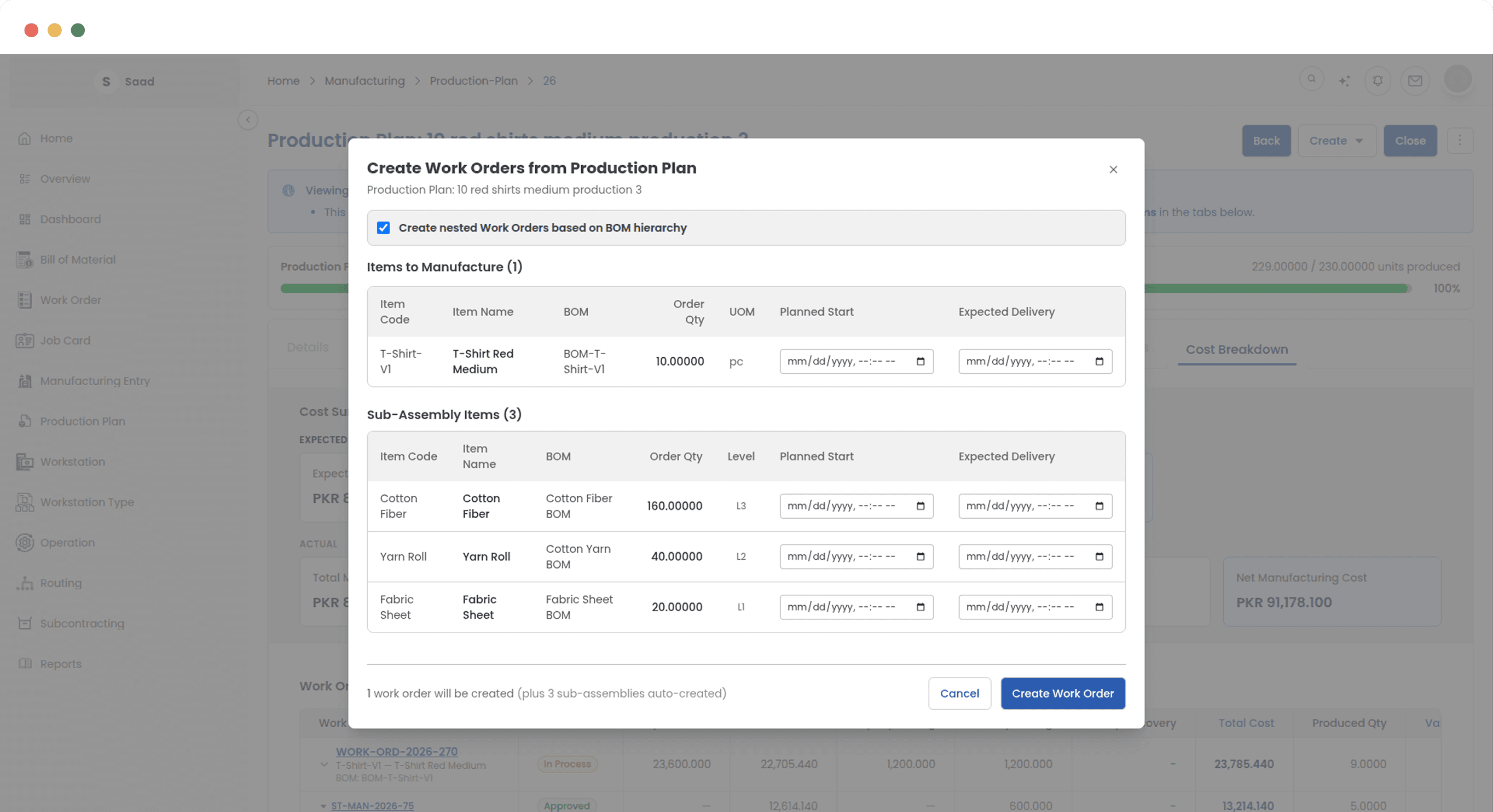

Generate work orders for the required items and linked sub-assemblies, then create job cards. Create purchase requests for material shortages and subcontracting orders for outsourced work.
Follow ordered, produced and remaining quantities for manufacturing items, along with requested and received raw materials. Use the material explosion view to investigate an unexpected requirement.

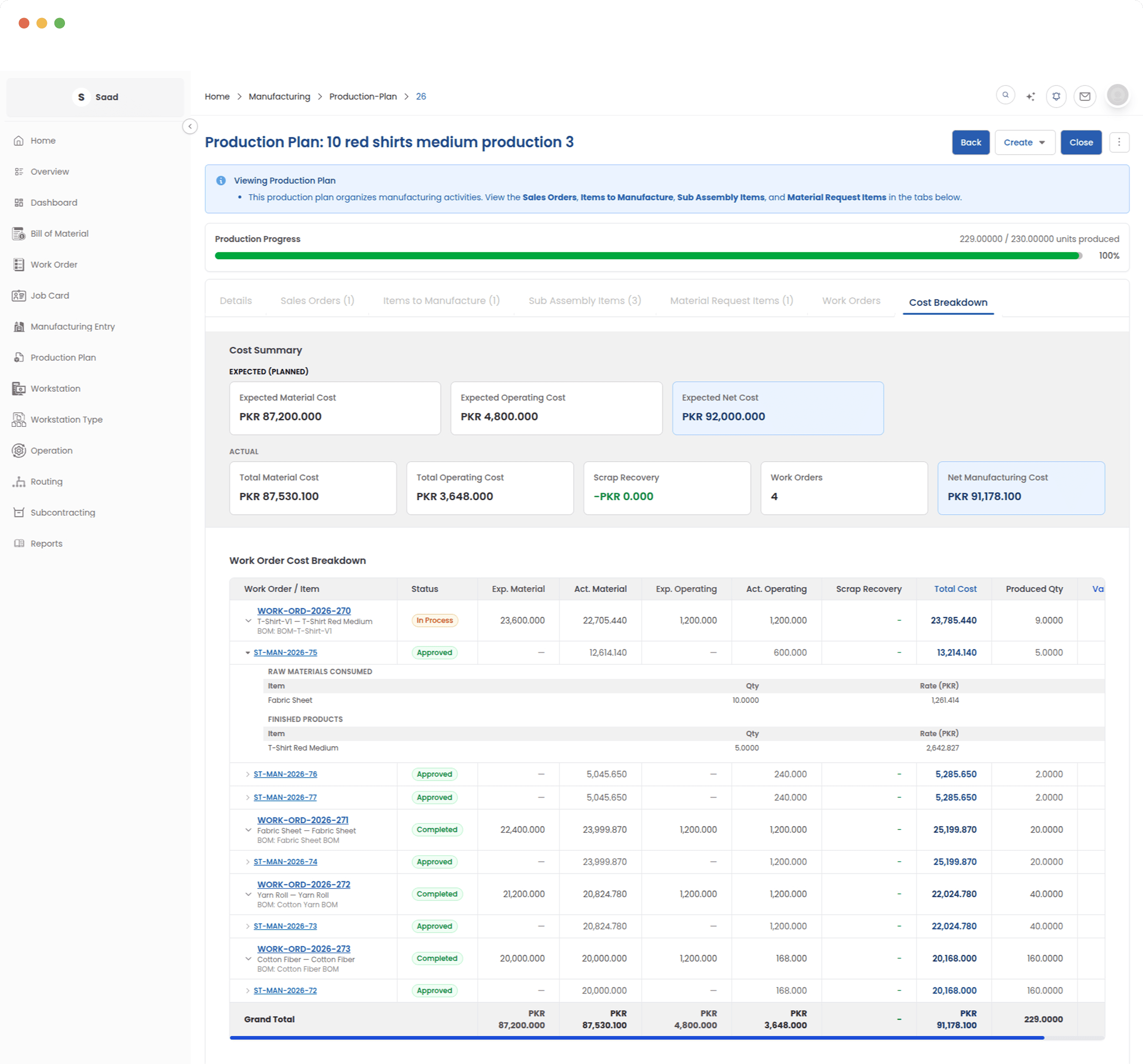

Adjust planned dates in bulk after work orders and job cards exist. Use capacity planning to test available hours; manufacturing administrators can also review the plan’s cost breakdown and export the relevant PDFs.

Hours and priorities
Choose a planning horizon and priority method, then calculate the schedule. Read the dependencies first, then use the calendar and utilisation views to identify the first overloaded resource.
Daily operating hours, active workstations, availability status, operation times, batch sizes and BOM routing all affect the calculation. Keep these records accurate before relying on the schedule.

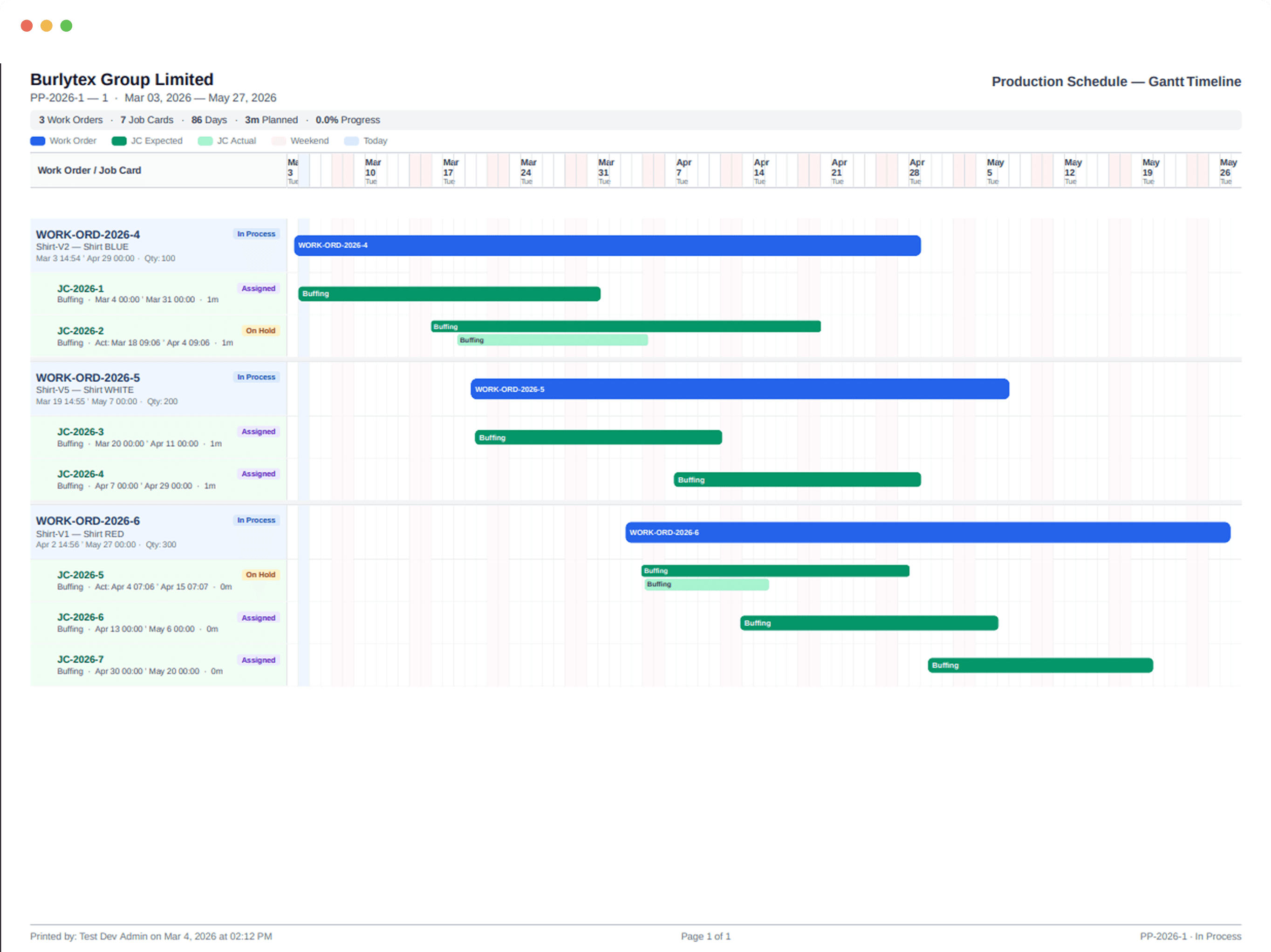

Expand a production plan to see its sub-assemblies and operations. Check the timeline for overlap or idle gaps and workstation utilisation for overloaded machine groups.
Change priority or allocation when appropriate, then calculate again. Adding capacity or moving a bottleneck can change later operations and the expected dates of several plans.

Planning decisions
Save the current result, test a different priority or capacity assumption, and compare the outcome. Future-demand simulation helps assess another order against the commitments already in the schedule.
Save a plan with the assumption in its name, such as Normal shifts or Extra finishing hours. Fetch restores the saved snapshot; Compare shows additions, removals and changes against the current result.
Simulated items are scheduled after real production plans. Simulation creates no production plan, reserves no stock and confirms no delivery date. Create the actual plan and recalculate when demand is confirmed.
A delivery-risk or no-capacity alert calls for reviewing the affected operation, its setup and usable machines. Export individual views or a combined PDF to share the assumptions and the proposed schedule.
Production example · illustrative figures
Illustrative example: two orders require 300 and 200 shirts. The plan uses 80 finished shirts already in stock. Each new shirt needs one collar and 2 m of main fabric; a collar BOM uses 10 m of collar fabric per 100 collars.
| Planning level | Gross requirement | Stock used | To make or request |
|---|---|---|---|
| Finished shirts | 300 + 200 = 500 shirts | 80 shirts | Make 420 shirts |
| Collar sub-assemblies | 420 collars | 120 collars | Make 300 collars |
| Main fabric | 420 × 2 m = 840 m | 500 m | Request 340 m |
| Collar fabric | 300 ÷ 100 × 10 m = 30 m | 10 m | Request 20 m |
The plan calls for 420 shirts, 300 new collars and purchase requests for 340 m of main fabric and 20 m of collar fabric. These figures assume no extra lot-size or tolerance adjustment. Stock moves later through the linked execution documents.
Production example · illustrative figures
Illustrative capacity check: a five-day week provides seven productive hours per machine each day. The following operation loads are assumed for the week; the table is a simple load check, not a calculated ERPX delivery schedule.
| Workstation type | Available capacity | Planned operation load | What to review |
|---|---|---|---|
| Cutting: 1 machine | 1 × 7 × 5 = 35 hours | 28 hours; 80% utilisation | 7 hours remain before other constraints |
| Stitching: 2 machines | 2 × 7 × 5 = 70 hours | 84 hours; 120% utilisation | 14 hours of excess load |
| Finishing: 1 machine | 1 × 7 × 5 = 35 hours | 21 hours; 60% utilisation | Spare hours depend on upstream completion |
Stitching is the bottleneck. Review priority, available compatible machines or additional operating hours, then recalculate the full operation sequence. Spare finishing hours alone do not remove the stitching delay or confirm a customer delivery date.
Product documentation
Find setup, production and reporting guidance for this part of ERPX Manufacturing.
Buyer questions
No. Approval makes the plan actionable so its work orders, job cards, purchase requests and subcontracting orders can be created. The plan does not move stock; stock movements happen through the documents used to execute the work.
Check finished-goods and sub-assembly stock utilisation, the BOM’s output batch quantity, material units and any safety-stock or minimum-order settings. Compare the non-stock and subcontracted-item inclusion options as well. The material explosion view helps trace a particular line.
No. Closing ends the planning record. Its linked work orders and purchase requests keep their own statuses and must be managed separately. Review outstanding documents before treating the production work as finished.
A production plan consolidates what needs making and which materials are required. Capacity planning tests when that work can fit the available workstations and hours. Its expected dates depend on resource setup, operation times, batch sizes and scheduling priorities.
No. Simulated demand is scheduled after real production plans, but it creates no plan, reserves no stock and confirms no delivery date. Once an order is confirmed, create its production plan and recalculate against the current commitments and capacity.
A saved plan is a snapshot of its inputs and calculation at that time. New demand, changed priorities, machine availability or revised operating hours can change today’s result. Use Compare to see what was added, removed or changed.
